From ballpark to breakdown: Understanding website development cost

September 21, 2025

Business

Development

Digital Strategy

website development cost

Every digital project begins with the same question: “How much will it cost?” Too often, the answer is a single number offered early in the sales cycle – a ballpark estimate. These figures may help secure internal budget approval, but when treated as commitments, they become the root cause of cost overruns, scope creep, and strained client–vendor relationships.

The problem is not that estimates exist. The problem is that estimates are misunderstood. They are seen as fixed price tags when, in reality, they are risk models that evolve with information. Understanding the difference between a ballpark and a breakdown – and knowing when to rely on each – is the key to controlling both budgets and outcomes.

The ballpark: Useful but dangerous

Every digital project begins with uncertainty. Before a single workshop is held or a requirement is documented, executives want to know one thing: “Roughly how much will this cost?” Vendors answer with a ballpark estimate – a directional range that might separate an initiative in the tens of thousands from one in the hundreds of thousands.

Ballparks are not guesswork. They are informed by a vendor’s past experience with similar projects and serve an important function: helping leaders decide whether a project is financially feasible, whether it deserves further exploration, or how it compares with competing initiatives in the portfolio.

But their utility comes with risk. By definition, a ballpark carries wide margins of error often ±50–70% – because the fundamentals of the project remain undefined: integrations, content volume, accessibility requirements, and user priorities. The danger arises when this early directional figure is treated as a promise. What was intended as a feasibility signal quickly becomes a contractual expectation, almost guaranteeing budget overruns and strained relationships once real scope emerges.

The distinction is critical: a ballpark answers “Is this initiative financially viable to explore?” It does not answer “What will it actually cost to deliver?”

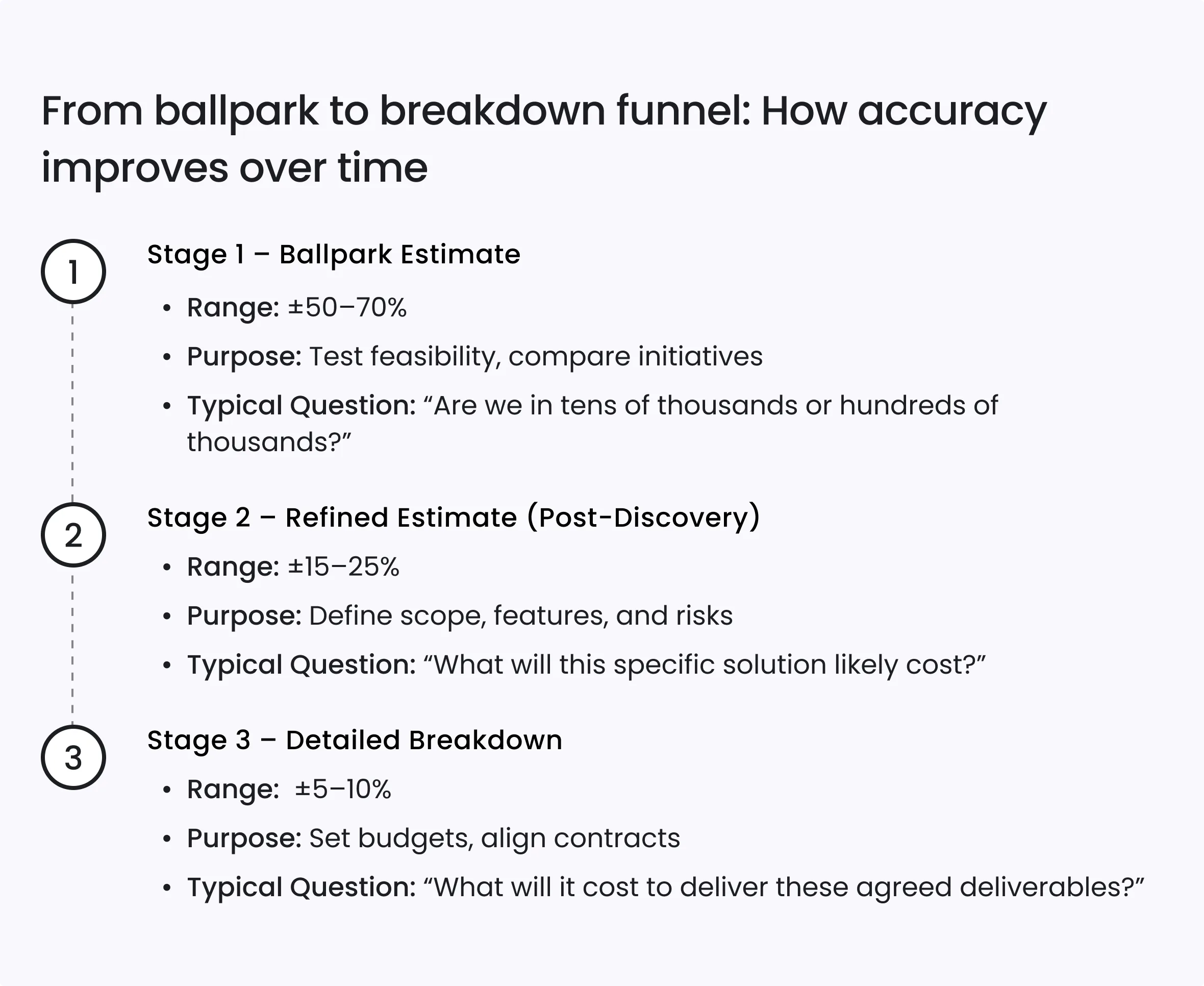

: From ballpark to breakdown funnel: How accuracy improves over time

The breakdown: How estimates gain precision

If a ballpark is about feasibility, a breakdown is about execution. As discovery unfolds, assumptions give way to evidence. Stakeholder interviews clarify not just goals, but trade-offs. User research identifies critical journeys and uncovers the hidden friction points that can make or break adoption. Technical audits reveal the realities of legacy systems, compliance requirements, and integration pathways. Content inventories often expose the underappreciated cost of migration – whether it’s thousands of PDFs, multilingual pages, or outdated CMS structures.

Each of these inputs narrows uncertainty. The wide margins of a ballpark begin to collapse into a range that is specific, defensible, and actionable. A breakdown estimate is not simply a spreadsheet with line items; it is a structured forecast grounded in research, technical evidence, and organizational priorities.

Hallmarks of a credible breakdown include:

  • Scope definition documented features, user flows, and integration points.
  • Risk assessment contingency planning for known unknowns.
  • Confidence ranges accuracy improves to ±15–25%, and tighter as phases progress.
  • Inclusions and exclusions explicit clarity about what is (and isn’t) included.
  • Dependencies clear articulation of assumptions (e.g., availability of internal teams, third-party vendor readiness).

Unlike a ballpark, a breakdown serves two purposes simultaneously. It is a budgeting tool, enabling leadership to allocate funds responsibly, and a governance mechanism, forcing alignment between business, design, and technical priorities before execution begins. By the time a breakdown is complete, leadership should not only know what the project is likely to cost but also why and what risks still remain.

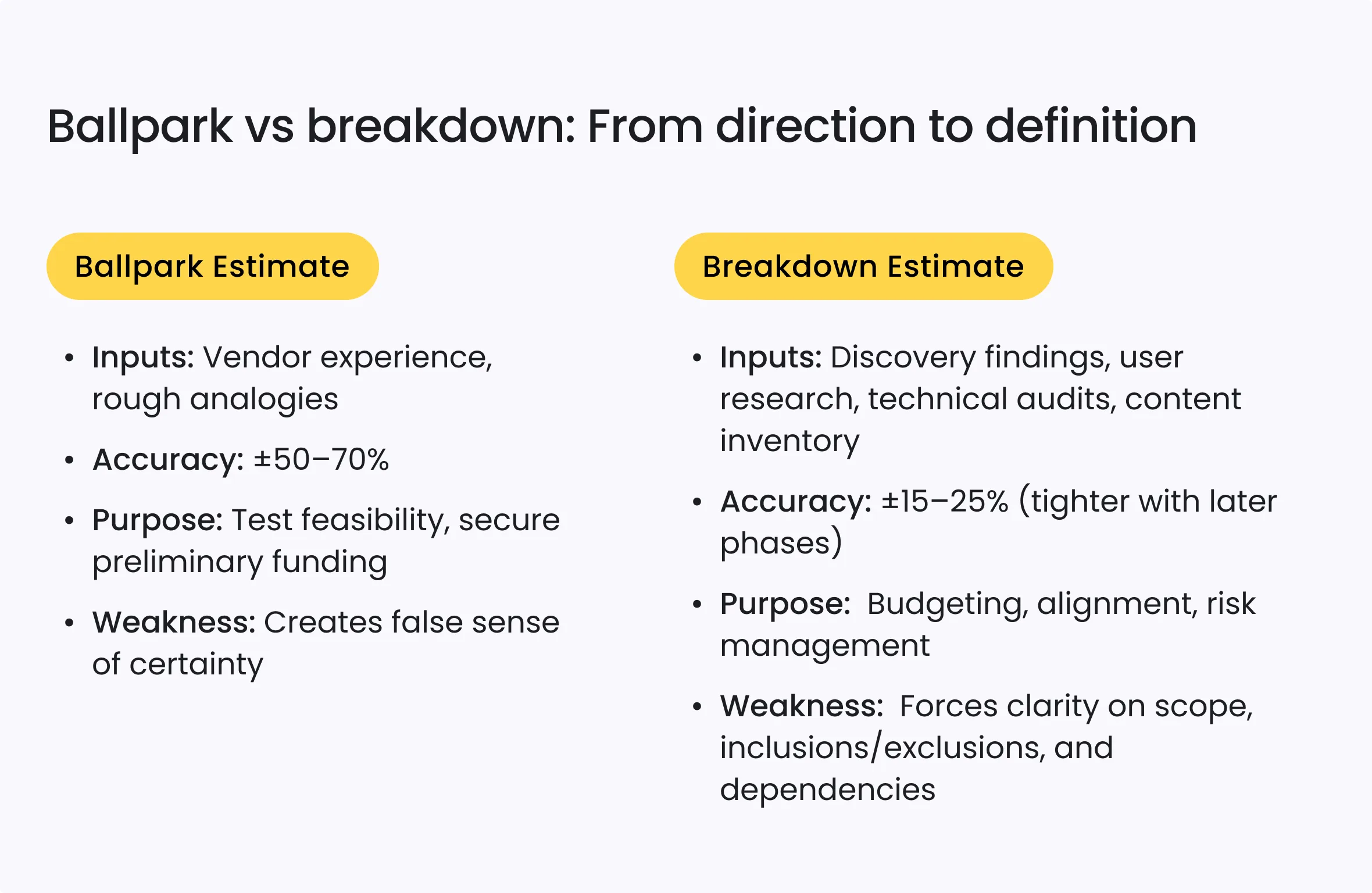

Ballpark vs breakdown: From direction to definition

The economics of accuracy

The impulse to compress planning and "get to build" is common. On paper, it looks faster. In practice, it is far more expensive. The economics of digital projects are unforgiving: the later an error is discovered, the more it costs to fix.

Decades of software engineering research confirm this multiplier effect. IEEE and IBM studies consistently show that a requirements error corrected in production costs 10–100 times more than if it had been addressed during planning. What feels like time saved at the front end often translates into months of rework and budget overruns later.

Other financial pressures reinforce the same lesson:

  • Downtime: Gartner estimates that IT downtime costs enterprises an average of $9,000 per minute (Forbes, 2024). Performance issues overlooked during planning can quickly cascade into major operational and financial losses.
  • Accessibility compliance: In 2024, U.S. courts saw 4,605 ADA website accessibility lawsuits (UsableNet, 2025). With the European Accessibility Act coming into force in June 2025, non-compliance is no longer just a reputational risk but a regulatory liability.
  • Rework: Late discoveries about integration complexity, data migration, or security gaps inflate budgets disproportionately. What might have been a minor adjustment in discovery becomes a major rebuild once development is underway.

Insight: Allocating just 5-10% of total project budget to structured discovery and detailed estimation is not overhead; it is insurance. Those upfront hours typically save multiples of that cost in execution, while reducing risk and accelerating time to value.

The cost of fixing errors over time: The multiplier effect of late fixes

What really drives website estimates

Executives often focus on visible factors like “number of pages” or “design complexity.” In practice, the largest cost drivers lie elsewhere – often hidden in integration complexity, compliance obligations, or organizational decision-making.

  • Integrations: Connecting a CMS to CRMs, SSO providers, payment gateways, DAM/PIM systems, or analytics platforms is rarely straightforward. Studies show that integration challenges are among the leading causes of cost overruns in enterprise IT projects.
  • Content migration: Modern migrations are rarely “copy and paste.” They are automated processes that require robust tooling, mapping, and validation. Complexity arises not from moving data, but from data modeling, metadata cleanup, redirects, taxonomy alignment, and exception handling. A single error in mapping thousands of nodes can break site functionality or SEO. Industry surveys note that content migration typically consumes 20–40% of total project effort in replatforming.
  • Accessibility & performance: Meeting WCAG 2.2 compliance is not optional. In 2024 alone, 4,605 ADA website accessibility lawsuits were filed in U.S. courts (UsableNet Report, 2025), while Core Web Vitals are now confirmed Google ranking factors.
  • Compliance & security: Data protection and resilience requirements continue to expand. Penetration testing and hosting compliance (HIPAA, GDPR, SOC 2) can add significant cost but are now standard in many sectors (IBM Cost of a Data Breach Report, 2024).
  • Governance: Perhaps the most overlooked driver. Inefficient decision-making, unclear accountability, and scope changes are cited as the top reasons for project overruns (Standish CHAOS Report, 2020 update).

Insight: Website cost is determined as much by how decisions are made and risks are managed as by the visible features stakeholders request.

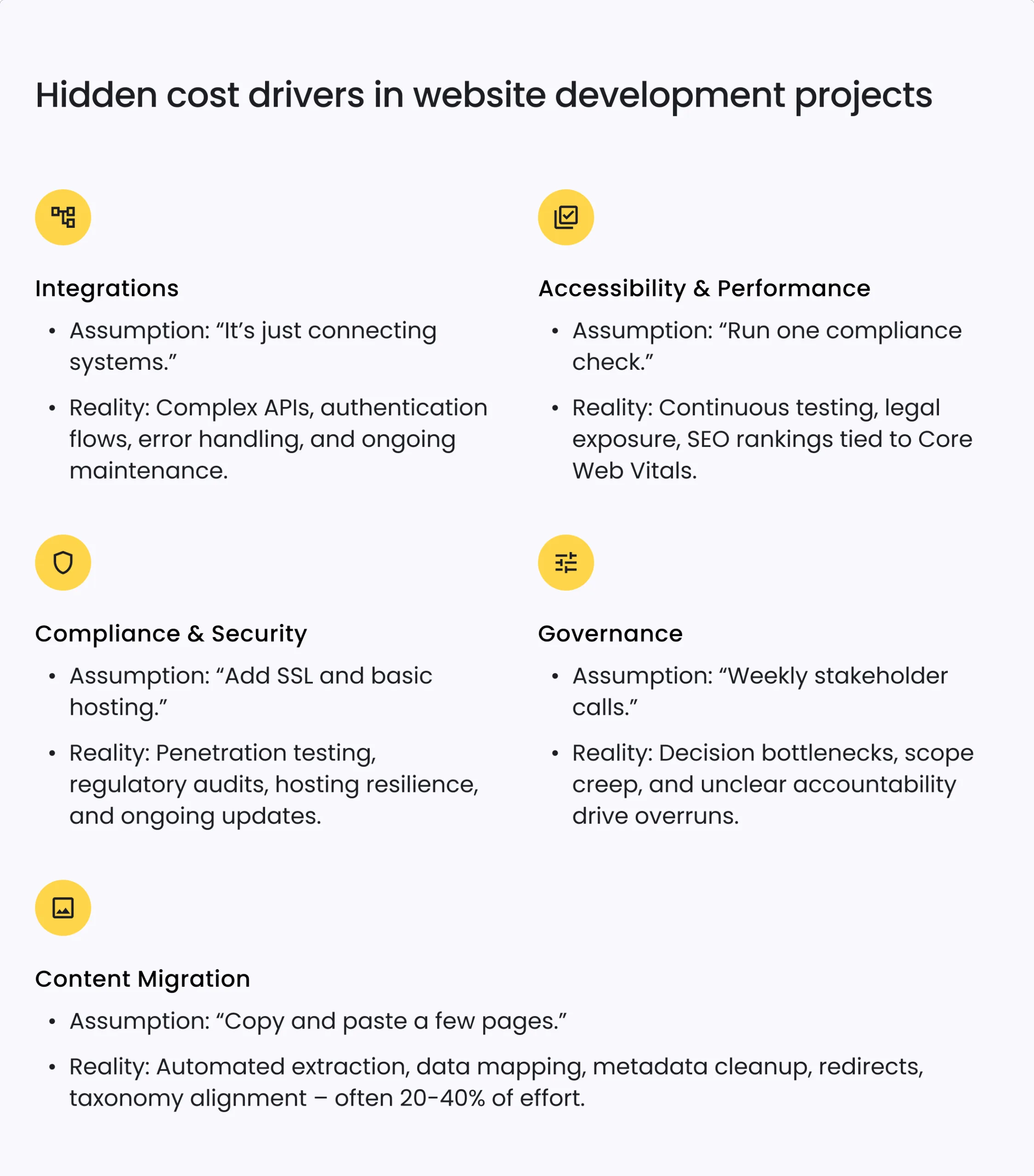

Hidden cost drivers in website development projects

How to read an estimate

When you receive a project estimate, don’t treat it as a promise. Treat it the way a CFO reads a financial forecast: as a model of risk, probability, and evolving certainty. The real value isn’t just the number – it’s the assumptions, ranges, and governance practices behind it.

Here are five questions you should always ask before trusting an estimate:

  1. What is the confidence range?
    If you’re given a single number, push back. A credible estimate should come as a range (e.g., ±15–25%) that narrows as discovery progresses.
  2. What assumptions is this based on?
    Every estimate rests on inclusions, exclusions, and dependencies. Ask for them explicitly – otherwise, you’re budgeting on wishful thinking.
  3. How are risks accounted for?
    Look for contingencies that cover “known unknowns” such as vendor delays, integration complexity, or regulatory requirements.
  4. What is the change-budget policy?
    Scope will evolve. You need to know in advance how new requests will be prioritized, funded, and approved.
  5. How will accuracy improve over time?
    Ask how the estimate will mature — from ballpark, to refined, to detailed breakdown. Transparency in that journey is as important as the numbers themselves.

When structured this way, an estimate becomes more than a financial tool. It becomes a governance mechanism:

  • It prevents scope creep by making priorities explicit.
  • It aligns marketing, IT, finance, and operations around the same assumptions.
  • It clarifies decision rights and approval processes.
  • It surfaces risks while there is still time to mitigate them.

Conclusion: From estimates to outcomes

The journey from a ballpark to a detailed breakdown is more than a budgeting exercise. It is a process of reducing uncertainty, aligning stakeholders, and safeguarding investments against the risks that derail so many digital initiatives. Ballparks test feasibility, breakdowns provide clarity, and well-read estimates become governance tools that keep projects on track.

The organizations that succeed treat estimates not as static numbers, but as living models of risk, confidence, and alignment. They ask the right questions, demand transparency in assumptions, and use estimation as a way to build consensus long before development begins.

At Five Jars, we structure our discovery and estimation process with this philosophy. Our approach blends strategic planning, technical auditing, and stakeholder alignment into estimates that do more than forecast cost they create confidence in outcomes. Learn how we approach estimation as part of digital strategy services.

And if your organization is preparing for its next digital initiative, let’s start the conversation. Contact us to begin building with clarity and confidence.

You may also like

Let’s work together!

Excited to learn more about your ideas and goals.

"*" indicates required fields

Accepted file types: pdf, doc, docx, Max. file size: 25 MB.
This field is for validation purposes and should be left unchanged.
